Ella Cityhomes
Ella Cityhomes buildingElla Cityhomes render
Construction Updates

Ella Cityhomes

Repair & Reconstruction Progress Updates

Contractor

TBD

A/E Firm

Knott Laboratory, LLC

Board President

Paco Varela

Project Launch

July 13, 2026

Knott Laboratory, LLC

Est. Completion

12-18 months

Project Overview

Welcome to the official project update page for Ella Cityhomes. This page provides ongoing updates for residents regarding progress, timelines, and important notices related to our community improvement project.

We are committed to keeping all homeowners informed throughout every phase of construction. Please check back regularly for the latest updates, and don't hesitate to reach out with any questions or concerns.

Ella Cityhomes construction

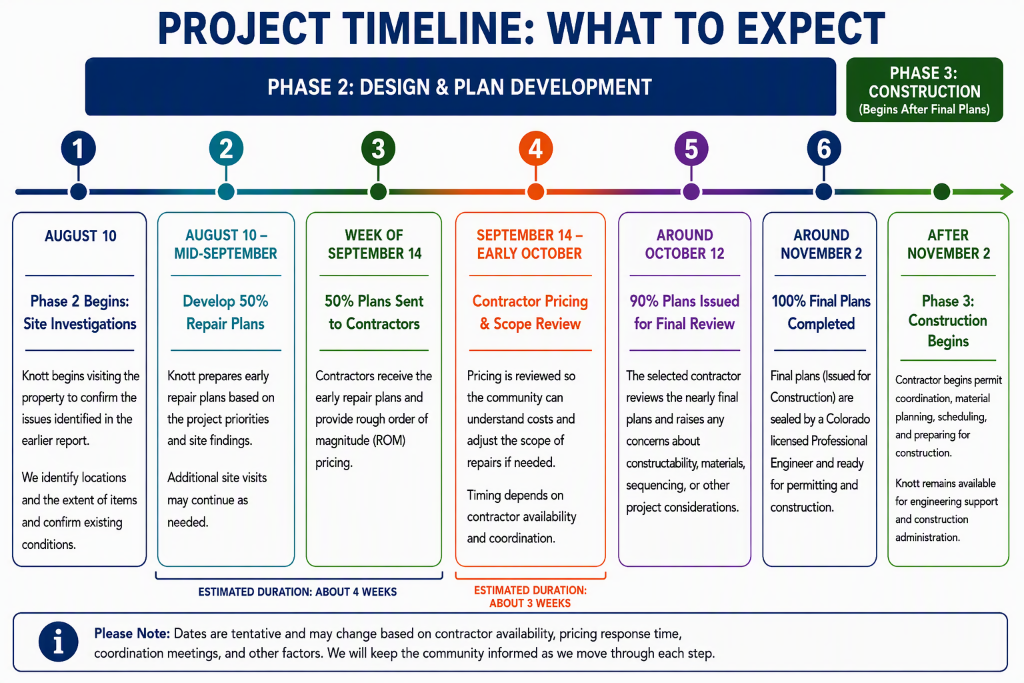

Project Timeline

A roadmap of what to expect across the upcoming phases.

Progress Updates

Follow our weekly construction progress below.

Phase 2
November 9, 2026

Construction Plans Sent for Bid

Repair recommendations have been reviewed and discussed with the board and we've assisted with the development of the request for proposals (RFPs) from contractors. The RFPs have been sent to 5 companies: ASR, EmpireWorks, Hall-Ryan, Kennedy-Ritcher, and Kindry Construction. Contractors have until 5pm on Friday, November 20 to respond with the selection made by the board on December 15. While we are attempting to stay aggressive on the timeline, we remain flexible and understand the factors involved. Our thanks to the board for their patience and ongoing efforts through the process.

Phase 2
October 21, 2026

50% Plan Sets Complete

The engineering team has completed the early repair plans from which cost estimating can begin. If you have any questions, please don't hesitate to ask using the form below.

Phase 2
September 24, 2026

Site Visits Completed

On-site inspections have now concluded. The engineering team is beginning work on the repair plans based on the site findings and prioritization.

Phase 1
September 9, 2026

Site Visits

On-site inspections are taking place this week and next. You should have received notices and direct communication regarding these visits. If you have any questions, please don't hesitate to fill out the form below.

Phase 1
July 28, 2026

Preconstruction Nearing Completion

Our document review is complete as is the initial site walk investigation. Our initial prioritization list has been compiled and presented to the HOA board. Additionally, the engineers have started to prepare for the Phase 2 process, which kicks off with multiple on-site assessments investigating areas of defects, damage, grading and drainage. These site visits will begin August 10 and are expected to continue for 4 weeks. We will provide more detailed updates on each week's site visits as we get closer.

Phase 1
July 13, 2026

Preconstruction Begins

Knott Laboratory's structural engineering team has begun Phase 1 - Preconstruction. In this phase, engineers are reviewing all construction and litigation documents to understand the location and extent of the defects. An initial site walk was performed to investigate areas of defects, damage, grading and drainage, and to understand the property as a whole. As this phase progresses, our engineers will list all repairs and prioritize them based on life and safety concerns, damage to buildings and/or property, and any potential community liability concerns. More information to come!

Frequently Asked Questions

Common questions about the project.

How can we help?

Have a question or concern? Reach out to us below.
